How to insert Progress Indicator in Excel

Progress visualization in Excel. A necessary component for project tracking. Several methods exist, each with varying degrees of complexity and visual impact. Let us examine these approaches.

Conditional Formatting with Data Bars provides a rapid, if somewhat rudimentary, means of representing progress. Input your percentage value, typically within a designated cell such as A1. Subsequently, select the range of cells where the visual indicator is desired. Navigate to the “Home” tab on the ribbon, then select “Conditional Formatting”, followed by “Data Bars”. Choose a color that aligns with your preferences. This action will generate a color-filled bar within the selected cells, visually corresponding to the input percentage. Further refinement is possible, although often neglected.

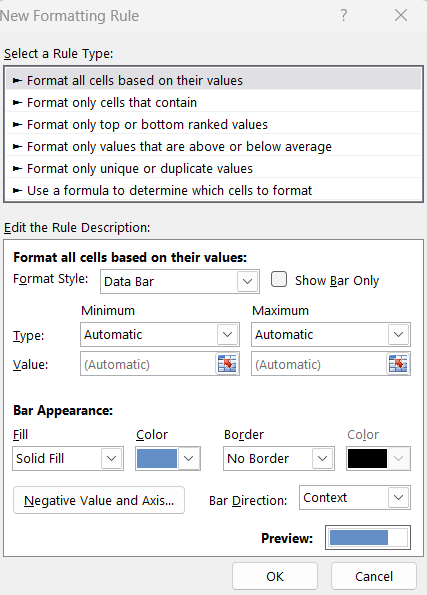

The “Manage Rules” option within Conditional Formatting permits a deeper level of customization. Selecting the specific rule applied allows for modification of colors, ranges, and other parameters. While offering greater control, this step is frequently bypassed due to time constraints or a lack of awareness. The resulting visual, while functional, may lack the precision desired for formal presentations.

Charts, specifically the Stacked Bar chart, offer a more structured approach. This method necessitates two distinct values: the percentage of completion and the percentage remaining. The latter can be readily calculated using a simple formula, such as =1-A1, leveraging Excel’s computational capabilities. This calculation ensures that the two values sum to 100%.

With the data prepared, select the cells containing these values. Proceed to the “Insert” tab and choose “Bar Chart”, specifically the “Stacked Bar” option. This action will generate a chart with two stacked bars, representing the two percentages. The key manipulation lies in rendering the “remaining” portion of the bar invisible. By selecting this segment, right-clicking, and choosing “Format Data Series”, you can set the fill to “No Fill”. This effectively removes the visual representation of the remaining percentage, leaving only the completed portion as a progress bar.

See also  How to create Excel file in C#

Customization options exist for both Conditional Formatting and charts. Within Conditional Formatting, rules can be established to alter the bar color based on the percentage value. This allows for a visual representation of progress thresholds, such as red for low completion, green for high completion, and amber for intermediate stages. Such visual cues provide at-a-glance assessments of project status.

Chart elements, such as width, labels, titles, and axes, can be adjusted to enhance clarity and aesthetics. However, excessive manipulation can detract from the primary purpose of the progress bar, potentially introducing visual clutter. A balance between functionality and visual appeal is crucial.

For interactive progress tracking, scroll bars offer a dynamic solution. Accessible via the “Developer” tab (which may require enabling through Excel’s options), the scroll bar allows for real-time manipulation of the progress percentage. Inserting a scroll bar and linking it to a designated cell enables a direct correlation between the scroll bar position and the cell’s value. As the scroll bar is dragged, the linked cell updates, dynamically altering the progress bar visualization. This interactive element provides a more engaging experience for monitoring project progression.

In conclusion, Excel offers a range of tools for creating progress visualizations. From the simplicity of Conditional Formatting to the more structured approach of charts and the interactive capabilities of scroll bars, users can select the method that best suits their needs. Each approach presents its own set of advantages and disadvantages, requiring careful consideration of the desired level of detail and interactivity. The judicious application of these techniques can significantly enhance the clarity and effectiveness of project tracking within Excel.
